Tung-Hsiao Power Plant 2nd Stage Renewal Project

Project Description

Background

In line with the government's energy policy and in response to the long-term growth in electricity demand, considering the retirement of existing units and the need to balance power development with environmental protection, Taipower is actively enhancing the overall operational performance and competitiveness of its power plants. Therefore, Taipower will increase the planning of natural gas power plants and, according to the latest long-term power development plan, promote the “Tung-Hsiao Power Plant 2nd Stage Renewal Project” (hereinafter referred to as “the Project”).

The Project will utilize approximately 10 hectares of land, including the vacant space left by the decommissioning of Units 4 and 5 at the Tung-Hsiao Power Plant and other remaining areas within the plant site. It plans to install gas-fired combined cycle units with a total net output of 270 to 330 MW, which is expected to promptly fill the future power supply gap.



Project Location and Scope

The Project will use the vacant land freed from the demolition of Units 4 and 5 at the Tung-Hsiao Power Plant site, along with remaining available plant space, to install five gas-fired combined cycle units.

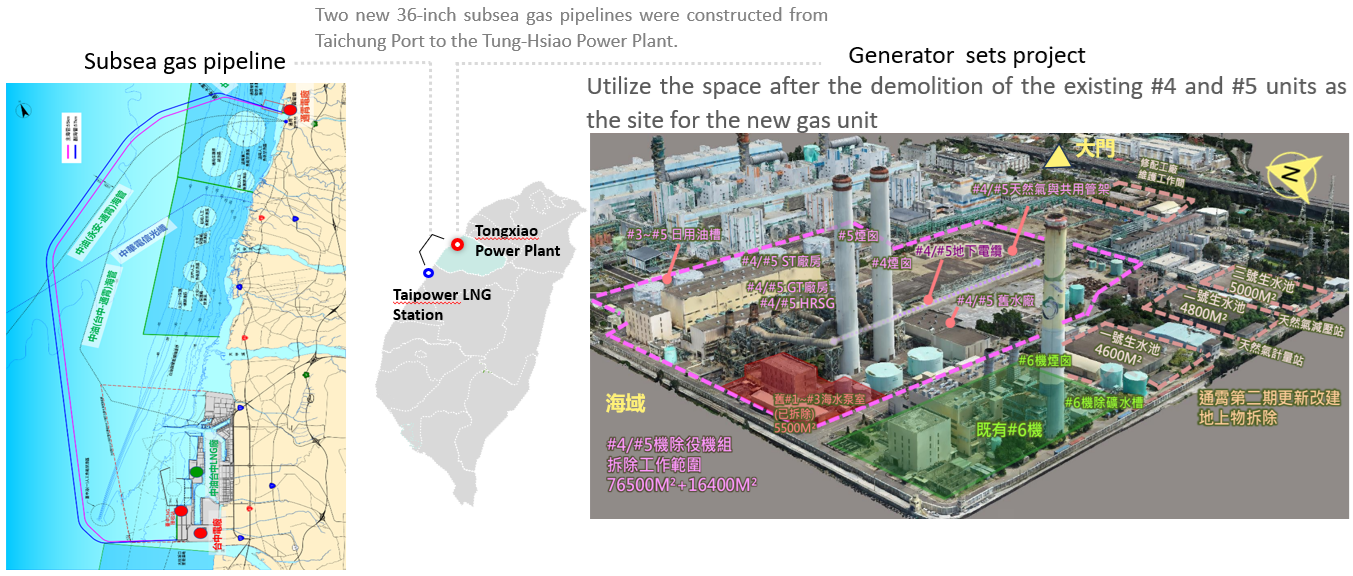

Tung-Hsiao Power Plant 2nd Stage Renewal Project Overview
Tung-Hsiao Power Plant 2nd Stage Renewal Project Overview



(New Design) Units Specification:

Item Parameters
Unit Number 5
Unit Capacity 2833 MW in Total; 566.6 MW each unit
Unit Type 1on1 Single-shaft Combined Cycle Unit
Thermal Efficiency 61.51% (LHV,Net)
Net Combustion 5,852 kJ / kWh (LHV,Net)
Gas turbine In-door type/ Heavy Duty for power generation/3,600 rpm
Steam Turbine In-door type /3,600 rpm
Heat Recovery Steam Generator (HRSG) In-door type / Triple-pressure reheating
Generator Air-Cooling / Three-phase Synchronous Machines / 3600 rpm
Main Transformer Outdoor, Oil immersion Type



Progress Status

Project Progress

Overall progress(%) (September-2025)
Schedule Actual Difference
32.94 32.94 0

Commercial Operation Date (COD)
Unit 4, 5 Unit 6, 7 Unit 8
2030/03/31 2030/11/30 2031/02/28
 The Project schedule amendment was officially approved by the Executive Yuan on Apr 2,2025.



Construction Status:

Power Block: The Bid for Power Block has been awarded on 2025/8/27, the winning tender is MPW (Mitsubishi Power Inc)/CTCI consortium team. The planning and design work is currently in progress.

Environmental Protection Planning

Related environmental protection actions can be referred to Taiwan Power Company Website and follow the following route: Information Disclose > Power Generation Information > Thermal Power Status and Performance > Environmental Protection Measures

  1. Install selective catalytic reduction system(SCR) to reduce air pollutant emission. (The emission concentration of other power plant can be referenced)

    Pollutant Emission Concentration
    NOx ≧70% load: 5 ppm;
    Annual average: 4 ppm.
